THE PLANS · THE SCALE · THE TIMELINE

What's actually being built, and when

Official plans first: the real architectural drawings, the government's own scale diagram, the published construction schedule, and the first physical work already on the ground — followed by clearly marked artist impressions showing what the disclosed scale could mean at eye level.

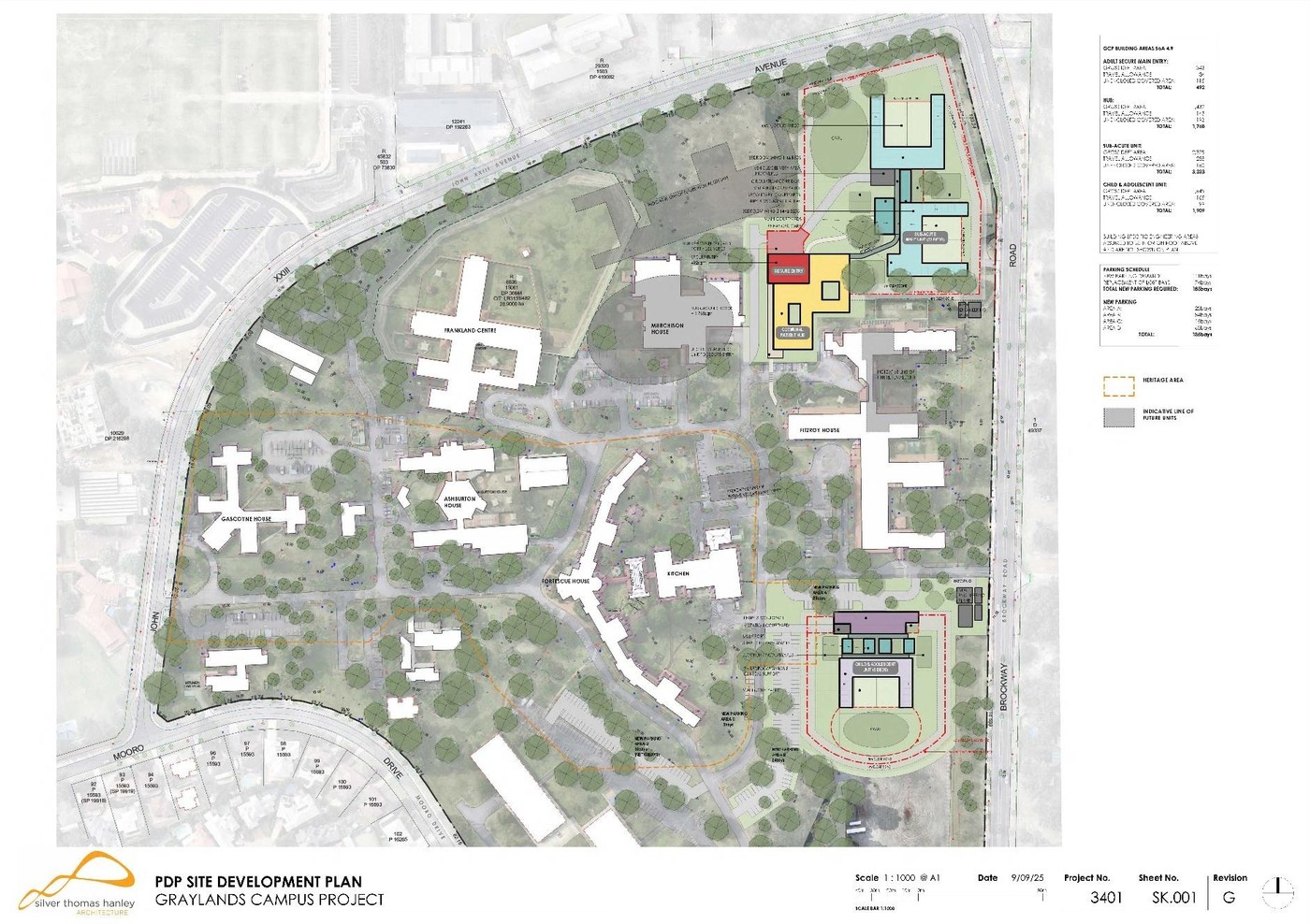

Site development plan from the State's 2025 Managing Contractor tender, showing the Adult Secure Main Entry, Hub and Sub-Acute Unit as coloured building footprints against the John XXIII Avenue boundary, and the separate Child and Adolescent Unit within its own fenced perimeter near Brockway Road.
The State's own site development plan for Stage 1 construction — Silver Thomas Hanley Architecture, drawing SK.001 Rev G, 9 September 2025. Source: EOI, Schedule 2

This is a living page. It will grow as more plans, drawings and dated evidence become available — each addition sourced and dated like everything else on this site. Last built: 14 September 2026.

40 new forensic beds — Stage 1, funded
176 beds at full build-out — only Stage 1 is funded
$698.3M estimated total capital cost
Q4 2028 targeted completion, Stage 1 works

Sources: EOI, Oct 2025 (Stage 1 scope and 2028 date); Infrastructure WA, Mar 2023 (full 176-bed vision and $698.3M).

What's being built, and where

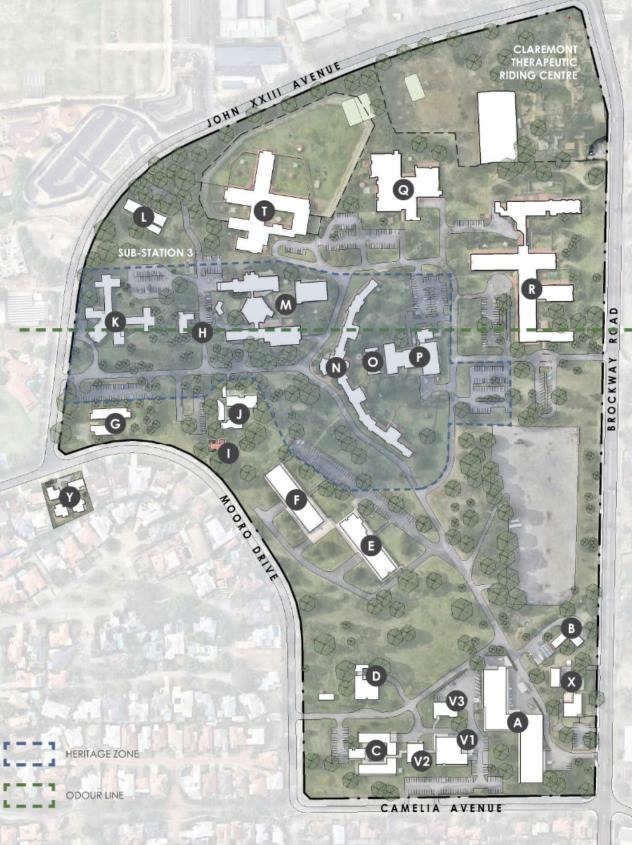

The plan at the top of this page is the site development plan the State issued to construction companies bidding to build Stage 1 — the first time the actual building footprints, not just bed numbers, have been made public. Set against what's there today, two things stand out.

Source: EOI Schedule 2, Parts A & B. Some smaller area figures on the original building schedule are too small to read reliably even at full resolution; we haven't guessed at them.

One secure compound today, growing to three

Frankland Centre operates today as a single secure, fenced facility — WA's only current forensic mental health unit. Nothing in the tender drawings shows it being decommissioned or its perimeter changed; it keeps operating throughout construction. Stage 1 adds two more secure compounds beside it, each with its own perimeter and its own set of security buffer zones: the Adult Secure Main Entry, Hub and Sub-Acute Unit cluster, and — separately — the Child and Adolescent Unit. One secure compound growing to three, on the same campus, before the long-term plan's further expansion is even considered.

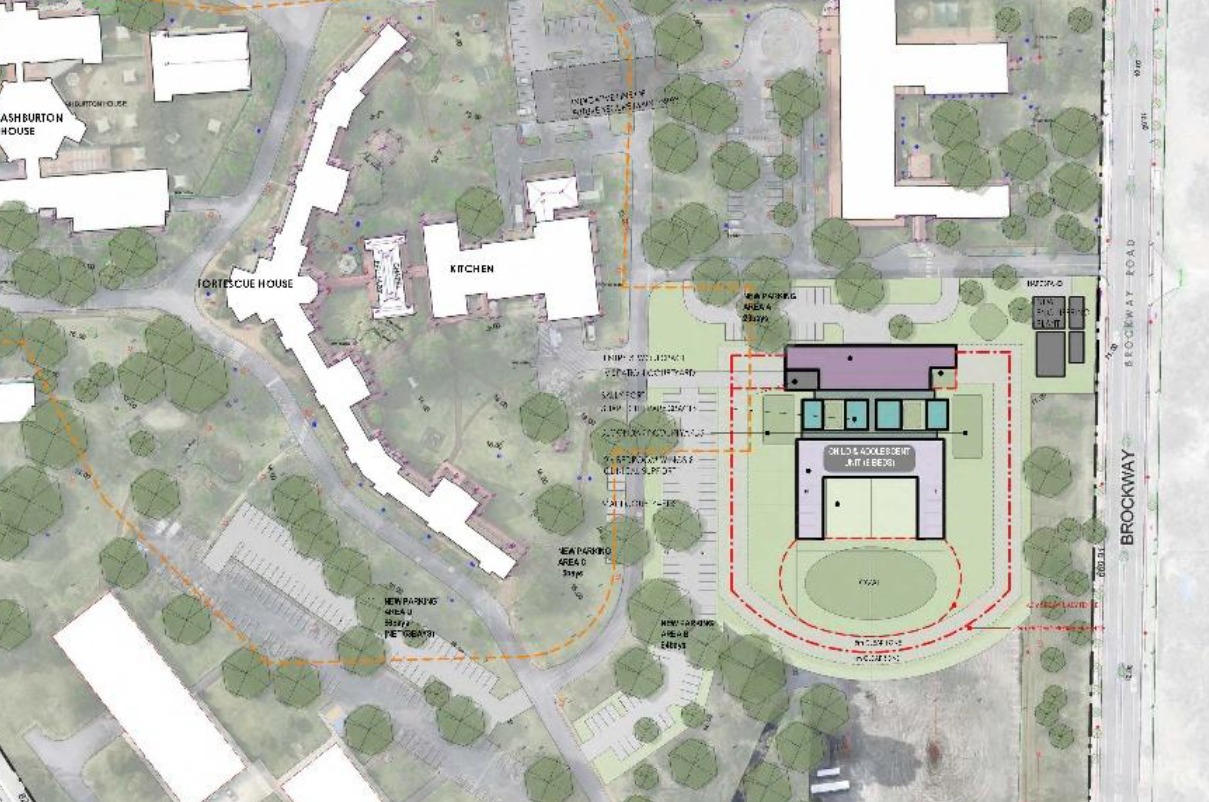

Both of the new compounds front directly onto a public road. The Adult Secure Main Entry cluster sits against John XXIII Avenue. The Child and Adolescent Unit sits against Brockway Road — the same road Quintilian School fronts, about 400 metres further south. Anyone driving or walking that stretch of Brockway Road will have a secure forensic compound on one side of the road and a primary school on the other, within a few hundred metres of each other.

Government has already told us how much land this disturbs — no estimate required for the headline number. The same RPS environmental report defines an "indicative disturbance area" of 3.54 hectares for the two new compounds, and says exactly what that figure covers: "the building/infrastructure footprints, inclusive of patient courtyards and secure perimeter, and perimeter management zones" — meaning the buildings, the yards inside the fence, the fence line itself, and all three buffer zones around it, combined RPS, Environmental Impact Summary, 1 Sep 2025, p.2. A regulation football pitch is 0.714 hectares. 3.54 hectares is close to five of them — disturbed, cleared, and brought inside a security-managed boundary, for two compounds that don't exist today.

That figure describes the two new compounds together; it isn't broken down per compound, and it isn't the same thing as "fenced compound" in the narrower sense — it also includes buffer strips that may sit outside the actual fence line, so treat it as the full managed footprint, not a literal fence measurement. For a sense of what's there today by that narrower measure: Frankland Centre's own compound, estimated from the scaled site plans and aerial imagery, covers approximately 1.4–1.6 hectares — around two football pitches on its own.

Put plainly: a compound covering around two football pitches today is being joined by two more compounds whose combined managed footprint — on the government's own figure — runs to nearly five football pitches more. Together, that's upward of five hectares of fenced, cleared, security-managed ground where there's just under two today — over three times the current footprint. There is no reading of those numbers where this is a modest addition. It's a step change in how much of this site is fenced, cleared and security-managed, right along two of Mount Claremont's busier roads.

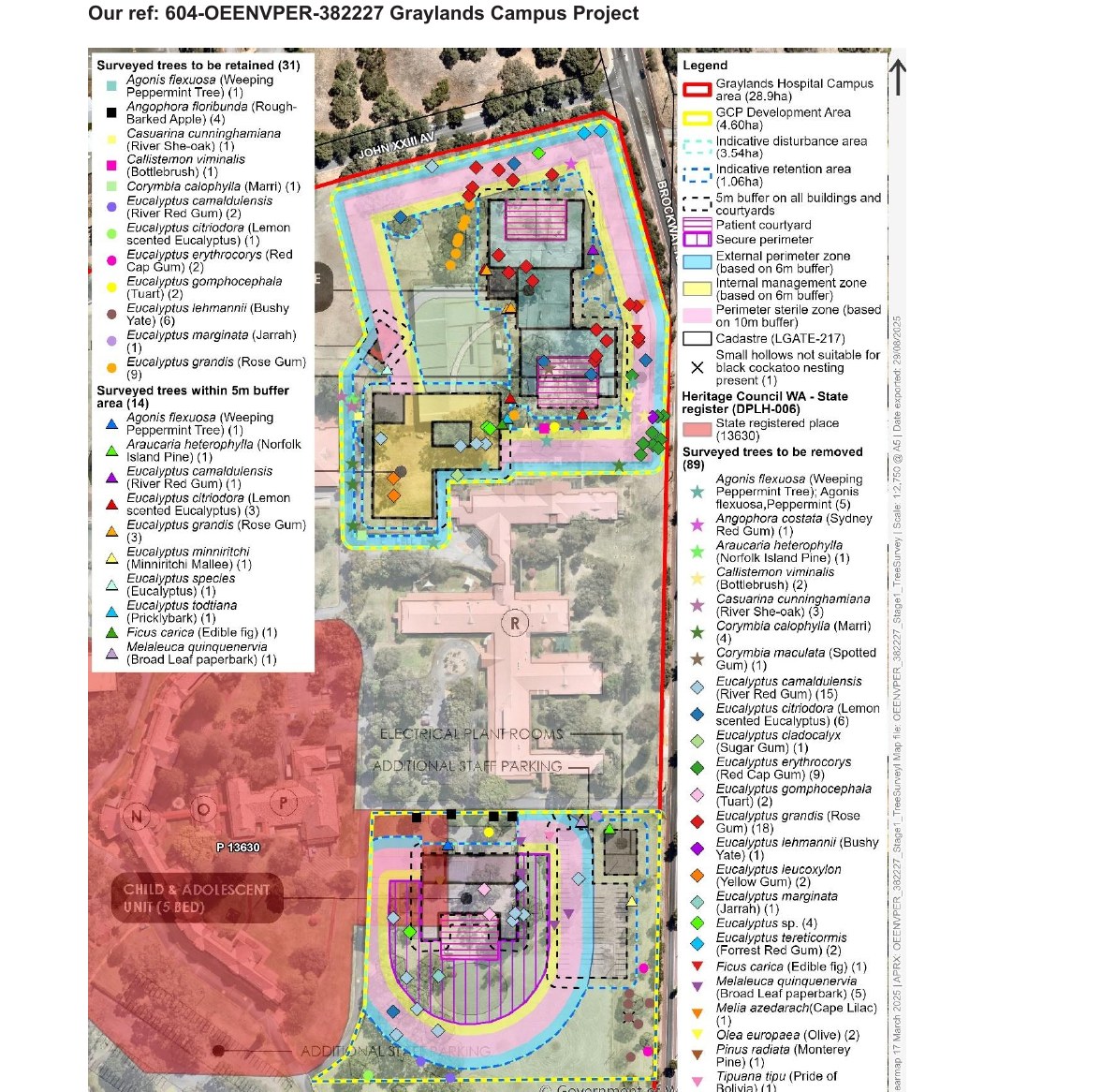

Government's own environmental consultant had to map the security architecture layer by layer to work out which trees could stay. Around each of the two new compounds, outside the secure perimeter itself, the design places three concentric zones: an external perimeter zone of 6 metres, an internal management zone of a further 6 metres, and — the consultant's own term — a perimeter sterile zone of 10 metres. Every tree standing inside any of those zones is marked for removal RPS, Environmental Impact Summary, 1 Sep 2025, pp.2, 18.

These three coloured zones must not be read as three fence lines. The RPS figure is a vegetation and disturbance assessment. Its coloured bands identify security-related planning and buffer areas around a separately marked "secure perimeter"; they are not a fencing schedule and do not establish how many physical barriers will be built.

The later tender site-development plan is the better available guide to alignment. Its linework appears to show a principal secure boundary around each new precinct, together with local courtyard and recreation-yard enclosures. But the published material still does not provide a complete fence legend, elevation or specification. Fence height, mesh, anti-climb treatment, lighting, surveillance and the final number and position of barriers therefore remain unconfirmed.

A dedicated secure perimeter is used because these facilities hold patients under detention or custody orders — not the informal, unlocked model of a general psychiatric ward. Absconding is already frequent at WA's existing facility, and failures cluster specifically at the transitions between security levels see Concern 1, the full documented record →. Going from one secure facility to three is not a cosmetic change in how the site looks. It creates two additional secure precincts and many more controlled transitions on one campus — and those transitions are exactly where the documented failures matter.

This is a construction and vegetation document, not a security plan. It shows the managed footprint and the consultant's zone terminology, but it does not establish three fence lines or disclose fence heights, detailed security treatments, lighting or surveillance.

ILLUSTRATIVE ONLY · NOT A GOVERNMENT DESIGN

What this scale could look like

The tender drawings show where the buildings and secure boundaries are proposed, but they do not show what the development may look or feel like from ground level. These impressions translate the publicly disclosed footprint into possible views so readers can understand the potential building mass, perimeter length, clearance areas and night-time presence.

Artist-impression disclaimer: These are campaign-produced artist impressions — not photographs, government renderings, architectural drawings or approved designs. They were prepared by the Mount Claremont Community Network from the publicly available tender site plan and environmental material as at 14 September 2026. We have not identified any published government external elevations, materials, final fence height or specification, lighting, surveillance design or verified public-view photomontages. Every depicted building, fence detail, landscape treatment, light and viewpoint is therefore illustrative and may differ materially from what is ultimately built. The government documents reproduced above remain the authoritative source for what has actually been disclosed.

Why publish impressions at all? Because plans read from above do not readily convey eye-level scale. These images do not fill the government's information gap with claimed facts; they make the gap visible while showing one plausible scenario based on the limited information available.

How close is close: the Child and Adolescent Unit

The school-boundary page above talks about the campus in general. This is about one specific, secure, fenced unit — and how close it sits to a school with around 160 young children.

Satellite map showing Graylands Hospital, the Secure Child and Adolescent Unit marked with its own fenced red perimeter, Shaw House, and the short distance along Brockway Road to Quintilian School and Moerlina School.
The Secure Child and Adolescent Unit sits inside its own fenced perimeter — approximately 400 metres from Quintilian School. Map: campaign annotation over satellite imagery, based on the tender site plans.

That's a fenced, secure unit for children and adolescents under a custody order, roughly 400 metres from a school gate. The perimeter shown isn't incidental — it's there because of who the unit is designed to hold, at a security level the government itself has classified as requiring a dedicated fenced boundary within the wider site.

The rest of the Stage 1 works

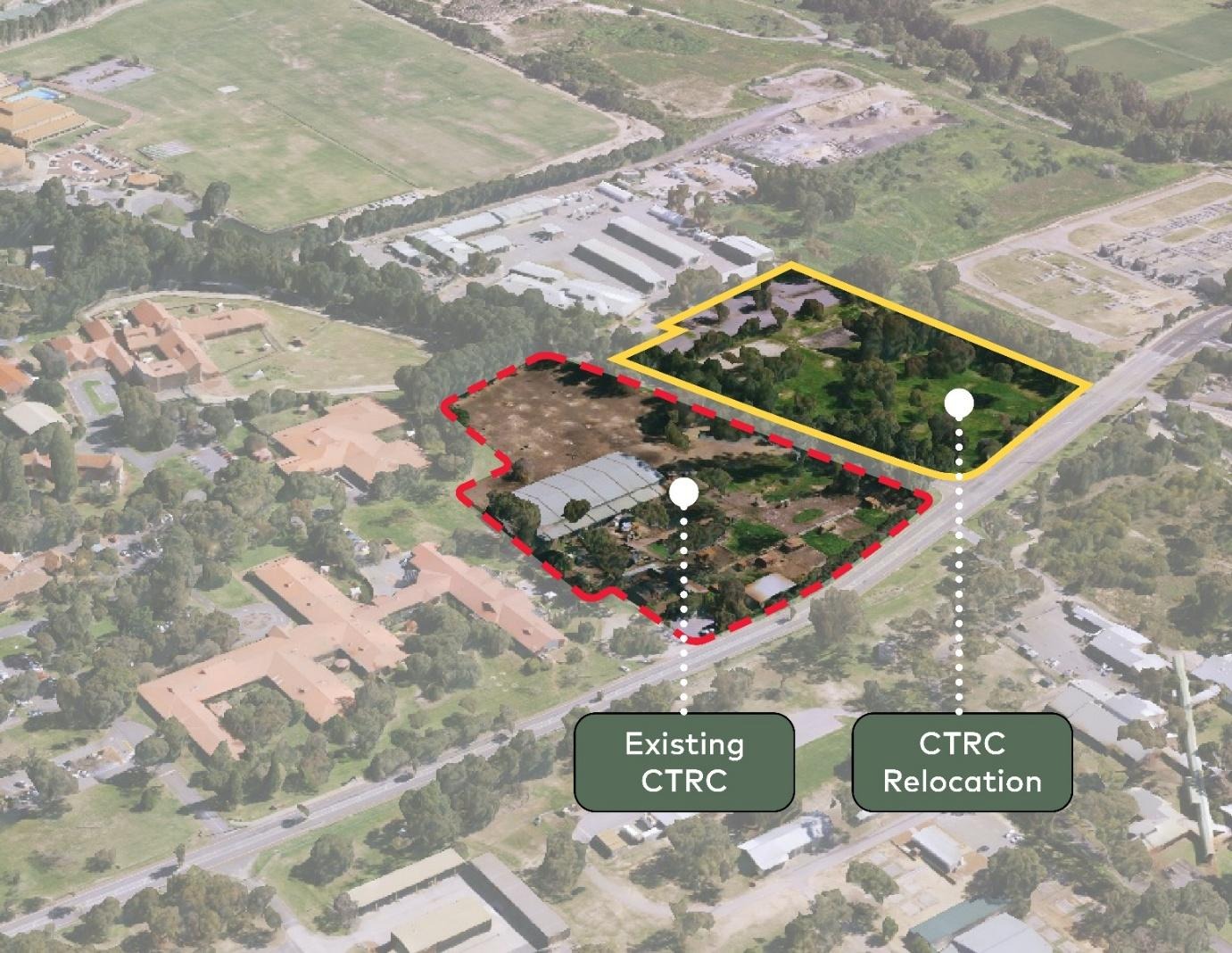

The tender also covers relocating the Claremont Therapeutic Riding Centre — which currently sits inside the footprint of the new build — to a new site across John XXIII Avenue. Government has allocated $10.6 million to the relocation WA Government media statement, 9 Apr 2026.

Source: EOI Schedule 2, Parts A & C

How big the full vision is

The tender above covers Stage 1 only — the 40-bed slice that's actually funded. The diagram below is different: it's the State's own original masterplan option for the entire northern campus, submitted to Infrastructure WA in December 2022 as part of the business case IWA reviewed in March 2023. It's the clearest single image of what "176 beds" actually looks like on the ground.

A risk flagged in 2022, before construction was even funded: Infrastructure WA's own assessment noted that "substantial redevelopment" on this site falls within the Subiaco wastewater treatment plant odour buffer, and recommended the impacts and mitigations be clearly set out before a funding decision. The same odour line is marked on both this 2022 masterplan and the existing site plan further up this page — we haven't been able to confirm whether the recommended assessment was ever published.

Source: Infrastructure WA, Major Infrastructure Proposal Assessment, March 2023

What's already there

The plans above sit inside an established, densely used neighbourhood — not a buffer zone. This is the same annotated aerial from the homepage, for reference alongside the plans on this page. How it came to look like this →

Annotated aerial map of Mount Claremont showing the Graylands site proposed for forensic expansion, with John XXIII College sharing its boundary, Quintilian School across the road, Moerlina School and Mount Claremont Primary nearby, and the Claremont Therapeutic Riding Centre adjoining the site.
Five schools, a disability riding centre and thousands of homes sit within a kilometre of the site. See the school on the boundary for the full breakdown and sources.

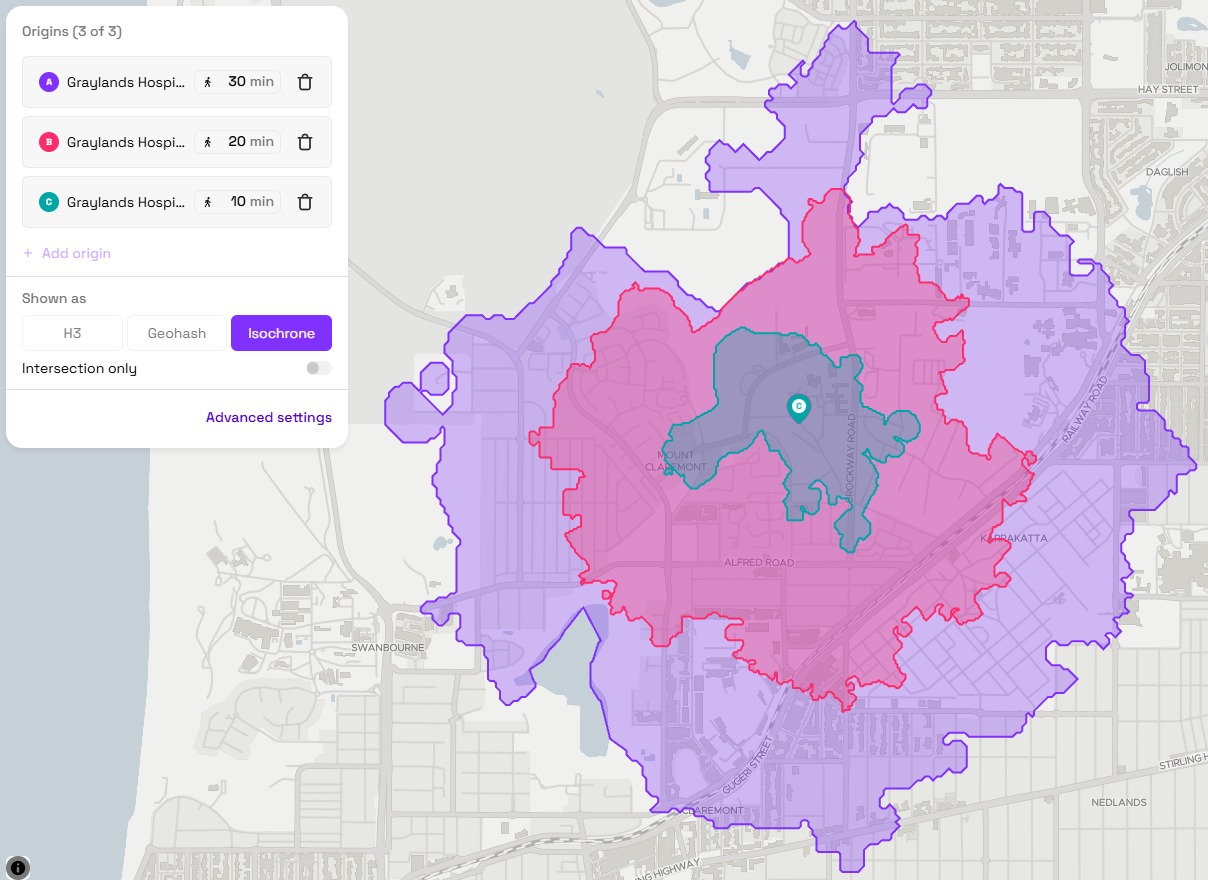

Walking-time isochrone map centred on Graylands Hospital, showing the area reachable on foot within 10, 20 and 30 minutes. The 30-minute walk reaches into Swanbourne, Karrakatta, Claremont and Nedlands; the 10-minute walk already covers a substantial residential area immediately around the campus.
The same neighbourhood, measured by actual walking time rather than a straight-line radius — the standard this campaign has asked government to apply when comparing sites, applied here to the one already chosen.

The published timeline

Two different processes, on two different clocks: the political/funding timeline already covered on the issue page, and the construction procurement timeline below, drawn from the tender documents themselves.

Mar 2023
Infrastructure WA's own assessment estimates transition to operations by July 2027.
16 Oct 2025
Managing Contractor tender (EOI) released for Stage 1 design and construction — Project No. 15821.
12 Nov 2025
EOI phase closes; the State moves to shortlist respondents for the Request for Proposals phase.
Q1 2026
RFP phase: shortlisted respondents receive the detailed project brief and draft contract.
9 Apr 2026
ADCO Constructions engaged under an Early Contractor Involvement contract — matching the EOI's own Q2 2026 target for executing the Managing Contractor agreement. The contract itself, awarded 23 March 2026, is on the public record at $5,619,001, published as an estimate rather than a fixed price Tenders WA, OMID2026017.
11 Jun 2026
Turner & Townsend awarded a cost-consultancy contract, $492,030, to oversee "the ECI and D&C Phases" of the project on the State's behalf — running to 30 April 2031 Tenders WA, OMID2026074.
26 Aug 2026
NMHS awards a $149,215 contract to develop a business case "to request funding to operationalise" the finished facility — the case for the money needed to actually run it, separate from the cost of building it Tenders WA, NMHS202616608.
Mid-2027
Government confirms in Parliament that the CTRC relocation is targeted for completion by this point, with main Graylands Campus Project works expected to follow it WA Parliament, QoN 3186, 15 Sep 2026.
Q2 2027
Contractor due to submit its Stage 2 offer, including a Guaranteed Construction Sum, to proceed to full construction.
Q4 2028
Targeted practical completion of all Stage 1 Managing Contractor works — 15–17 months later than Infrastructure WA's original July 2027 estimate, depending where in Q4 completion lands.

Sources: EOI, Oct 2025; Infrastructure WA, Mar 2023. The EOI can't name the winning contractor since it predates selection, but the scope and dates line up closely with the ADCO engagement above.

Every contract behind that timeline

The dates above are the headline moments. The government's own contract-disclosure register has the full paper trail behind them: 28 contracts for planning, design and early works, awarded between October 2022 and August 2026, totalling $8,958,992 — none of it for construction itself. Twenty firms have been paid so far, from the architects who scoped the earliest options through to ADCO Constructions and Turner & Townsend above.

This isn't the project's cost. $8,958,992 is what's been paid for planning, advice and early contractor involvement — the announced $698.3 million capital figure at the top of this page is separate, and covers something much larger. What this register shows is sequence: who was contracted, when, for what, and how it built up to where things stand now.

See every contract, every firm and every source document →

On the ground now

LATEST SIGHTING

3 September 2026 — a resident stopped to speak with a work crew carrying out electrical infrastructure work at the John XXIII Avenue boundary of the site. Asked what it was for, the crew confirmed it was for the proposed development.

It's the first physical sign most residents have seen with their own eyes — and it lines up with the EOI's own Q2 2026 target for site works to begin. OMID's own project fact sheet, reissued in September 2026, lists "October 2026" against "works to relocate the CTRC commenced" — a month later than the same claim in the August 2026 edition OMID, Graylands Campus Project Fact Sheet, Sep 2026. The same document still lists "construction commences" against "to be determined." Parliament has since put a shape on what follows: the government told the Legislative Assembly the CTRC relocation is targeted for mid-2027, with the campus's main works expected to follow it WA Parliament, QoN 3186, 15 Sep 2026 — the clearest sequencing confirmed so far, even though "construction commences" itself remains undated.

What the government's own tender says about community reaction

Project delivery objectives — Managing Contractor tender, Oct 2025

"Stakeholders – deliver the Project engaging proactively and positively with the community without causing any adverse stakeholder reaction."

One of seven listed project objectives, alongside quality, schedule, cost and safety. Source: EOI, Section 2.3

Read plainly, the objective isn't to seek community agreement — it's to avoid a negative reaction becoming a delivery risk. That's a reasonable thing for a construction schedule to worry about. It's a different thing from genuine consultation, which is the entire basis of this campaign's ask.

If seeing the actual plans changes how "176 beds" or "$698 million" lands for you, the petition is the fastest way to register that.

Sign the petition
